Tijdlijn OEM elektrische tandenborstel: Procesgids per week (2026)
Project timelines depend on product scope, tooling, approvals, testing, supplier readiness, freight, customs, and destination. Use the calendar below as a planning example, then confirm milestones against the project and current availability.

Samenvatting: OEM elektrische tandenborstel productietijdlijn
- Standaard OEM Tijdlijn: 12–16 weeks (84–112 days) is an illustrative inquiry-to-delivery planning range, not a guaranteed lead time. Confirm the project schedule.
- An existing-platform ODM project may avoid some structural tooling if the model and configuration fit. MOQ, customization, setup charges, testing, and timing depend on the product and written terms.
- Top vertragingsrisico's: Schedule risks can include design changes, testing availability, supplier closures, component or packaging readiness, freight, and customs. Set project-specific buffers and confirm dates with the relevant providers.
- Payment and tooling milestones are negotiated contract terms. Specify deposits, balance triggers, tooling ownership, acceptance conditions, and nonconformity handling in the signed agreement.
In deze gids
- Volledige tijdlijn in een oogopslag
- Fase 1: Onderzoek & Fabrieksselectie (Weken 1-2)
- Fase 2: Ontwikkeling van monsters en prototypes (weken 3-8)
- Fase 3: massaproductie (weken 9-12)
- Fase 4: Verzending en inklaring (weken 13-16)
- Existing-platform ODM options
- Top vertragingsrisico's en hoe ze te voorkomen
- Omgekeerde kalenderplanning: Werk achterwaarts vanaf je lanceerdatum
- Veelgestelde vragen
1. Volledige tijdlijn in een oogopslag
Voordat je in individuele weken duikt, is dit het complete plaatje. Als je de algemene vorm van de tijdlijn kent, kun je beter onderhandelen met fabrieken, realistische lanceerdata vaststellen en bepalen waar buffertijd het belangrijkst is.

Over de fabrikant: Relish Technologie
Relish Technology has manufactured oral-care products since 2012. Its operations in Shenzhen and Huizhou total 20,000 m². Share the product configuration, target market, order scope, and schedule to discuss relevant manufacturing options and product-specific documentation.
Meer informatie → · Casestudies van klanten → · Bekijk certificeringen →

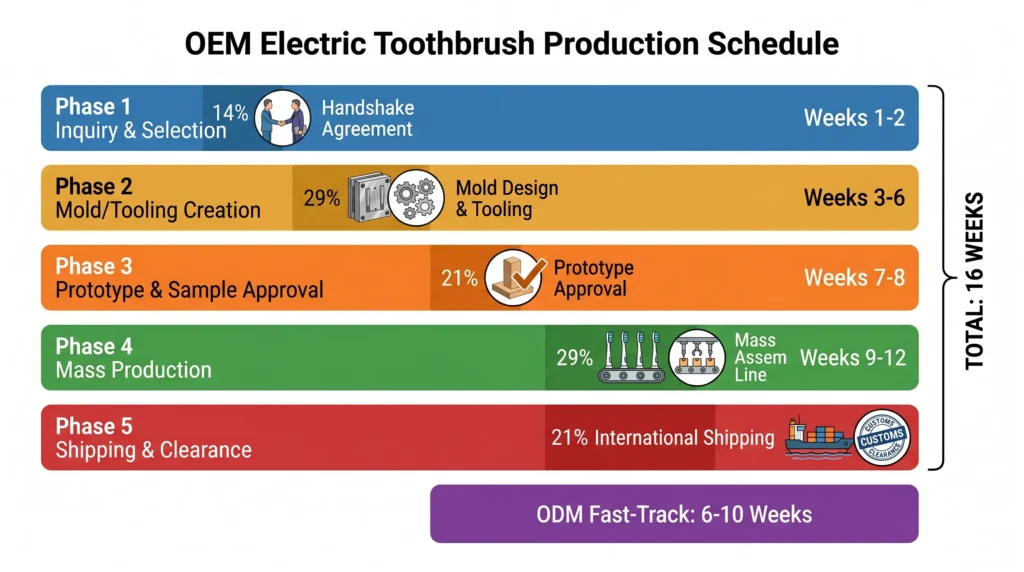

OEM Electric Toothbrush: Illustrative 16-Week Timeline (Visual Overview)
| Fase | Weken | Belangrijkste activiteiten | Uw beslissingspunten |
|---|---|---|---|
| 1. Onderzoek & selectie | 1-2 | RFQ, offertevergelijking, ondertekening NDA, shortlist fabriek | Fabriek kiezen, specificaties bevestigen |
| 2. Mallen maken | 3-6 | Engineeringbeoordeling, matrijsfabricage, eerste matrijsproef | Ontwerp matrijs goedkeuren, aanbetaling gereedschap betalen |
| 3. Prototype en goedkeuring | 7-8 | Eerste monsters, testen, revisies, tekenen voor productie | Monsters goedkeuren, inkooporder ondertekenen |
| 4. Massaproductie | 9-12 | Production deposit, inline checks, packaging, and pre-shipment inspection: schedule and payment terms are project-specific and contractual. | Review inspection results and follow the payment terms agreed in the contract. |
| 5. Verzending en opruiming | 13-16 | Zee-/luchtvracht, douane-expediteur, levering op de laatste kilometers | Ontvangst bevestigen, inventaris bijhouden |
Een nummer om te onthouden
Use the 16-week calendar as an example, then build a project-specific schedule. Add time for design changes, sample review, testing, transport, and clearance after confirming requirements with each supplier or service provider.
2. Fase 1 - Onderzoek & Fabrieksselectie (Weken 1-2)
Early supplier evaluation helps clarify product scope, documentation, commercial terms, and schedule assumptions before tooling or production begins.

RFQ-voorbereiding & Multi-Factory Outreach
AanvraagBegin week 1 met het schrijven van een duidelijke, gedetailleerde Offerteaanvraag (RFQ) en tegelijkertijd naar 4-6 fabrieken sturen. De kwaliteit van je RFQ bepaalt de kwaliteit van de offertes die je terugkrijgt. Vage verzoeken krijgen vage antwoorden en opgeblazen prijzen die pas later duidelijk worden.
- Define product specifications: Drive technology and specified motion metric, battery voltage and capacity/Wh, applicable ingress-protection target, handle dimensions, brush-head type, charging method, and operating modes.
- Bepaal je doelhoeveelheden: Vermeld je initiële bestelhoeveelheid en je verwachte jaarlijkse volume. Fabrieken hanteren verschillende prijzen voor 500 vs. 5.000 stuks
- List destination-market compliance requirements: identify applicable product rules and evidence for the model and configuration; confirm testing and documentation with the laboratory or qualified adviser.
- Specificeer de verpakkingsvereisten: Afmetingen van de detailhandeldoos, insteekkaart, masterverpakking, labelvereisten die klaar zijn voor Amazon
- Identificeer 4-6 kandidaat-fabrieken: Gebruik Canton Fair directories, Alibaba Gold Supplier filter, Made-in-China.com of directe verwijzingen.
Een complete RFQ omvat deze acht punten
Productnaam en een beschrijving van 1-2 regels. Een technisch specificatieblad met afmetingen, materialen en prestatiedoelen. Je doelmarkt(en) en vereiste certificeringen. De initiële bestelhoeveelheid plus een prognose van het volume voor 12 maanden. Specificatie van de verpakking voor zowel de detailhandel als de hoofdverpakking. Vereisten voor de hoeveelheid monsters en doorlooptijd. Richtprijs FOB - dit is optioneel, maar helpt bij het uitfilteren van fabrieken die niet concurrerend zijn binnen jouw bereik. En de verwachte betalingsvoorwaarden.
Offerte-evaluatie en fabrieksselectie
SelectieCompare quotations on identical specifications, quantity, Incoterms, testing, packaging, and documentation. Assess total landed cost and assumptions; price alone does not establish supplier quality or future rework cost.
- Vergelijk offertes op dezelfde basis: Controleer of alle offertes dezelfde Incoterms gebruiken (meestal FOB Shenzhen), dezelfde certificeringen bevatten en identieke verpakkingsspecificaties hebben.
- Verify the supplier: Check its business registration and any claimed ISO 9001 certificate. For comparable products, request model-specific test reports and conformity documents relevant to your target market. CE is a conformity mark; FCC requirements depend on the product configuration.
- Evalueer de communicatiesnelheid: Track response times during evaluation and agree on communication expectations and escalation contacts before production.
- Fabrieksprofiel aanvragen: Hoeveel productielijnen? Jaarlijkse capaciteit? Huidige grote klanten (geanonimiseerd)? Hebben ze al eerder geëxporteerd naar je doelmarkt?
- Shortlist suppliers for further review. If needed, commission a scoped factory audit and obtain a current quotation from the provider.
Hoe een betrouwbare fabriek eruit ziet
A supplier should explain its capabilities, identify open technical questions, provide current documentation for comparable products, and agree on a practical communication and review process. Verify claims against the project scope.
Loop weg als je dit ziet
Investigate inconsistent quotations, unclear documentation, or pressure to skip written terms. Compare like-for-like costs and seek clarification; no single signal proves fraud.
3. Fase 2 - Ontwikkeling van monsters en prototypes (weken 3-8)
Sample development may take several weeks and require review rounds. Consolidate feedback, document approved changes, and evaluate new requirements against the schedule.

Engineeringcontrole en bevestiging van het matrijsontwerp
Tooling KickoffAfter scope and commercial terms are agreed, engineering reviews design, tooling, materials, assembly, and available processes. The number of questions and response time depend on the project.
- DFM review: Ask engineering to identify design, tooling, assembly, and process questions and document any proposed changes.
- Review proposed CAD and tooling designs before authorizing fabrication. Changes after work begins may affect engineering, time, and cost; define approval and tooling ownership in writing.
- Materiaalbevestiging: Specificaties handvatmateriaal (ABS / PC / ABS+PC mix), borstelmateriaal (nylon kwaliteit / DuPont Tynex) en TPE/rubber overmold bevestigen
- Document the relevant vibration or brush-head movement metric and test method; distinguish VPM, Hz, and rotational speed. Do not call sonic operation ultrasonic without supporting frequency data.
- Tooling cost and payment timing depend on design and contract. Agree amount, ownership, acceptance milestone, and payment triggers in writing.
Matrijzenbouw (CNC-verspaning)
GereedschapDuring mold fabrication, request updates at agreed milestones. Toolmaking requires inspection and adjustment; the appropriate correction depends on the issue and engineering assessment.
- Tooling lead time and durability depend on design, material, process, workload, production conditions, and maintenance. Obtain a project-specific estimate.
- Vraag om voortgangsfoto's: Vraag naar CNC-bewerkingsfoto's bij 50% en 100% afwerking
- Parallelle taken tijdens deze wachttijd:
- Definieer merklogo en kleurenpalet voor schimmeltextuur
- Ontwerpverpakking voor de fabriek
- Ask your testing lab to review the rules and test scope for the intended product and destination markets.
- Prepare importer-of-record arrangements if required for the destination and transaction.
- Tool life depends on grade, heat treatment, mold design, resin, production conditions, and maintenance; quoted shot counts are not universal guarantees.
Verspil geen weken 4-5 met wachten
Use the mold fabrication period to finalize packaging design and send it to the factory for a mockup. Register barcodes (EAN/UPC) for each SKU early enough to support listing and packaging preparation. Prepare listing copy, warehouse arrangements, and draft manuals while tooling is underway. Review regulatory requirements with the laboratory early; product testing and final approvals may need representative samples.
Eerste schimmelproef & T1-monsters
Eerste opnamenA first mold trial (often called T1) evaluates molded parts and fit. It may identify dimensional, surface, or assembly issues and is not necessarily a complete functional product.
- T1 dimensionale inspectie: De fabriek meet kritieke afmetingen ten opzichte van uw goedgekeurde tekeningen met behulp van CMM (coördinatenmeetmachine) of schuifmaten.
- Beoordeling van de oppervlakteafwerking: Controleer de textuur, glansgraad, zichtbaarheid van de deellijn en eventuele verzakkingen of lasnaden.
- Assemblageproces: Behuizingshelften worden geassembleerd met de interne componenten (PCB, motor, batterij) om de passing en tolerantie te controleren.
- T1 findings and corrective actions:
- Inspect flash, sink marks, weld lines, fit, and surface texture against the drawing and sample criteria.
- Ask engineering to identify root cause before approving a design, process, or tooling change.
- Record corrective actions and re-trial timing in the project schedule; no single repair or turnaround applies to every case.
- Review the updated sample before approving the next stage.
- Vraag T1 monsters fysiek verzonden aan: Zelfs met foto's onthult de evaluatie in de praktijk dingen die een camera mist. Tactiele kwaliteit, gewichtsverdeling, knopgevoel

Preproductiesample (functioneel prototype) & testen
TestenThe pre-production sample should represent the agreed design closely enough for review. Define tests, sample size, conditions, acceptance criteria, and any changes requiring reassessment.
- Functional sample testing:
- Battery runtime: Define sample, charge state, operating mode, load, and stop criteria. One condition does not establish runtime for every mode or battery.
- IPX7 immersion: Use applicable IEC 60529 conditions, commonly 1 m for 30 minutes for the relevant enclosure. Longer duration is not an IPX7 requirement; an air-pressure screen is not the water test.
- Valtest: Agree sample, height, surface, orientations, repetitions, and pass criteria in the project protocol.
- Brush-head attachment: Define sample, cycle count, and evaluation criteria in the product specification.
- Charging/cycle test: Specify charger, battery, cycle count, measurements, and acceptance criteria.
- Vibration measurement: Document instrument, measurement point, method, and metric; distinguish sonic vibration from ultrasonic frequency and rotational speed.
- Temperature test: Define product state, exposure duration, operating condition, and criteria; limited testing does not prove all-environment performance.
- Proefversie verpakking: Controleer de bedrukte kleuren van de detailhandeldoos (vraag om een Pantone-nauwkeurige proef), de scanbaarheid van de streepjescode en de pasvorm van de insteekkaart.
- User manual review: Check labeling and instructions against the requirements applicable to each destination market and product configuration.
Voordat je het pre-productiemonster goedkeurt
Compare the production-representative sample and documented results against the agreed specifications and criteria. Determine whether changes require further testing or approval before production.
Bevestiging inkooporder & productieplanning
Kickoff massaproductieAfter sample and commercial terms are approved, issue a purchase order and confirm the production slot. Define specifications, quantity, price, delivery terms, inspection criteria, and payment schedule in writing.
- Formele PO uitgeven: In de ondertekende inkooporder moeten de exacte hoeveelheden per SKU, de eenheidsprijs, de Incoterms, de leveringstermijn, de verpakkingsspecificaties en de betalingsvoorwaarden worden vermeld.
- Bevestiging van het productieschema: De fabriek levert een Gantt-diagram of productieschema met startdatum, geschatte voltooiing en QC-mijlpalen
- Component procurement: Confirm availability and lead times for specified PCBs, batteries, motors, and materials with the supplier; update the project schedule if an item is not ready.
- Packaging production kickoff: Coordinate artwork approval, production quantity, and delivery timing with the packaging supplier and assembly schedule.
- Inspection planning: Agree the inspection scope, provider, sample plan, and timing with the supplier and inspector; availability varies.
4. Fase 3 - Massaproductie (Weken 9-12)
Agree on status updates and records to be shared. Use documented progress, inspection results, and issue tracking; follow the supplier agreement and site rules.

Actieve productie en inline kwaliteitscontrole
ProductieDocument production checkpoints, test coverage, sample plans, limits, and failure handling against the approved specification.
- Inline quality checkpoints (document the agreed plan):
- Housing: check dimensions and visible defects against the approved specification and sampling plan.
- PCB: document test coverage and limits; describe a check as 100% only if each unit receives the stated test.
- Assembly: verify alignment and seals against the specification. An air-pressure screen is not an IEC 60529 water-ingress test.
- Final function: identify the functions tested per unit and how failures are recorded and handled.
- Packaging: verify SKU, labels, accessories, and carton data against the approved specification.
- Vraag wekelijks productiefoto's/video's aan: Voltooide eenheden op de lijn, QC inspectieverslagen en verpakkingslijn in werking
- De voortgang van de productie bijhouden: For example, compare reported output with the production schedule and order quantity; investigate material variances early.
- If testing is required, confirm representative samples, scope, lab schedule, and production-change implications with the lab; timing is not guaranteed.
Tussentijdse rode vlaggen: handel hier onmiddellijk naar
If the factory goes quiet without explanation, something is wrong. If they suddenly ask to substitute a component because of "stock issues," push back—get the original spec or a written explanation. If production pace falls significantly behind schedule with no clear reason, escalate. If a supplier requests payment ahead of an agreed milestone, compare the request with the contract and resolve any discrepancy in writing before payment.

Voltooiing van productie en inspectie voor verzending
QC en inspectiePre-shipment inspection can check goods against the agreed purchase order and acceptance plan. Define scope and process in advance; it does not guarantee every shipped unit.
- Inspectie vóór verzending:
- Quantity: compare physical count with the PO and any tolerance expressly agreed in contract.
- Sampling: specify procedure, inspection level, sample size, defect classes, and acceptance/rejection numbers. AQL is a plan parameter, not measured defect rate; MIL-STD-1916 uses verification levels, not an AQL table.
- Workmanship: assess surface, color, assembly, and agreed criteria.
- Function: identify test functions, sample plan, and pass criteria.
- Packaging: verify carton markings, accessories, and barcodes against the approved specification.
- Carton drop testing: use the agreed protocol for height, orientations, surface, repetitions, and acceptance criteria.
- Choose an independent provider, buyer-appointed representative, or supplier records based on the agreed scope and evidence requirements. Fees and availability vary; confirm in writing.
- Document the nonconformity, corrective action, rework, and re-inspection criteria. Added time depends on the issue and agreed disposition.
- Prepare documents according to route, product, battery configuration, destination, and buyer requirements. Use a certificate of origin or conformity document only when applicable.
Voldoe aan de criteria voor inspectie vóór verzending
Use the quantity, sampling plan, function checks, packaging, markings, and documents in the contract. If results miss criteria, document corrective action and verify closure before shipment.
5. Fase 4 - Verzending en douane-inklaring (weken 13-16)
Shipping and customs timing depends on route, carrier, service, documents, battery configuration, port conditions, and clearance. Treat the week numbers as illustrative and confirm the current plan.

Vracht ophalen & Douane uitvoer (kant China)
VertrekThe forwarder coordinates pickup and export formalities. Clearance timing depends on the shipment and its documents; confirm cutoffs and required records for the chosen service.
- Sea freight planning examples:
- Shenzhen to Los Angeles: request a current route and service estimate.
- Shenzhen to Hamburg or Rotterdam: request a current route and service estimate.
- Shenzhen to Tokyo or Osaka: request a current route and service estimate.
- Shenzhen to Sydney: request a current route and service estimate.
- Air freight may suit samples or urgent shipments. Transit and cost depend on route, service, chargeable weight, battery acceptance, and current capacity; compare current quotes.
- Classification depends on product configuration, jurisdiction, origin, and import date. Treat HS 8509.80 only as a possible heading to investigate, not a final national tariff code or duty.
- Shipment document checklist (confirm what applies):
- Commercial invoice with accurate transaction value and required shipment information.
- Packing list with package count, weights, dimensions, and contents as required.
- Bill of Lading or Air Waybill for the selected service.
- Certificate of origin only if required by destination, buyer, or applicable procedure; confirm correct form and origin rules.
- Applicable conformity documentation for the product and destination.
- FCC documentation only when applicable to the product and import.
- Battery test summary and shipping information required for the battery design and shipment mode.
Kritisch: Naleving van verzendvoorschriften voor lithiumbatterijen
For lithium-battery products, identify battery type, watt-hours, packing configuration, shipment mode, and applicable rules. Obtain the required UN 38.3 test summary and confirm declarations and labels for that shipment; air and sea rules differ.
In-transit en import douanevoorbereiding
DoorvoerPrepare import paperwork before arrival. Confirm free time, storage or demurrage terms, and broker deadlines from current carrier and port information; charges vary.
- Share documents according to the broker’s agreed lead time. Pre-arrival review can identify gaps; no fixed number of days applies to every shipment.
- For applicable U.S. vessel shipments, determine whether ISF applies and submit required information within the regulatory timeframe before loading. ISF is not a general air-freight filing.
- For EU imports, confirm the economic operator and importer arrangements, applicable conformity documents, and customs registration requirements with the importer and broker. Keep these separate from the rules for Great Britain and Northern Ireland.
- Confirm the conformity route for Great Britain or Northern Ireland and the product. Great Britain recognizes CE alongside UKCA for many applicable products under current arrangements; Northern Ireland differs.
- Invoerrechten om te budgetteren:
- US: duty and additional tariffs depend on final classification, origin, product details, and import date. Check current official sources and obtain broker advice.
- EU: determine duty from the final classification, origin, and import date; do not rely on a generic percentage.
- UK: determine duty from the final commodity code, origin, and import date.
- Prepare fulfillment requirements before dispatch. For Amazon FBA, confirm current carton, labeling, prep, and shipment-plan requirements in Seller Central; these differ from standard third-party logistics.
Levering, ontvangst en inventaris Go-Live
AankomstDe vracht wordt ingeklaard en afgeleverd bij je magazijn of fulfillmentcentrum. Het OEM-project is voltooid. Maar het werk is nog niet gedaan. Ontvangst is een kwaliteitscontrolepunt dat veel merken ten nadele overslaan.
- Reconcile carton count and visible condition, then inspect units under the receiving plan agreed for the order. Any percentage sample is project-specific, not universal.
- Inventarissysteem bijwerken: Log lotnummers, productiedata en batchcodes. Dit is belangrijk voor garantieclaims en mogelijke terugroepacties
- Amazon FBA receiving (if applicable): Reconcile delivered cartons and monitor receiving status against the shipment plan created before dispatch. Inventory availability depends on Amazon's processing.
- Fotografie en listing update: Als je nog geen productfotografie hebt, regel dan meteen een in-house of studioshoot. Je wilt dat aanbiedingen live zijn binnen enkele dagen nadat de voorraad beschikbaar is.
- Debriefing van het project: Documenteer wat goed ging, wat voor vertragingen zorgde en wat je anders zou doen. Dit wordt je SOP voor de volgende productierun.
Klaar om uw OEM elektrische tandenborstel project te starten?
Share your project brief to discuss a quotation and schedule. Scope, MOQ, tooling, testing, sample terms, and current capacity depend on the product and written agreement.
Wat is je beoogde lanceerdatum? Vermeld het in het formulier - wij vertellen je of de tijdslijn realistisch is.
6. Existing-Platform ODM Options
ODM may suit a project that fits an existing platform and available configuration. New tooling may still be needed for structural changes; branding, accessories, packaging, testing, and schedule depend on the agreed scope. Compare total cost, MOQ, rights, and timing with an OEM proposal.
Custom OEM: A project-specific design may involve engineering and structural tooling. Confirm timeline, tooling charges, MOQ, design scope, and intellectual-property rights in the written agreement.

Existing-platform ODM: An existing platform may reduce some development or tooling work if it fits the brief. Confirm customization limits, setup charges, MOQ, testing, schedule, and intellectual-property rights in the written agreement.
Illustrative ODM Milestones
The sequence below shows how work may progress on an existing platform; confirm sample, production, freight, and receiving dates for the actual project.
| Week | Activiteit | Belangrijkste actie voor jou |
|---|---|---|
| Week 1 | Browse existing-platform options, if available, and request project-specific samples. | Review product fit, configuration, sample terms, MOQ, and schedule. |
| Week 2 | Monstereenheden ontvangen; functionaliteit testen; selectie bevestigen | Productmodel goedkeuren |
| Week 3 | Branding indienen: logo, kleuren, verpakkingsontwerp | Zorg voor complete merkactiva |
| Week 4 | Fabriek bereidt aangepaste pre-productie monster | Monster beoordelen en goedkeuren |
| Week 5 | Issue the purchase order and follow the written payment terms. | Uitgifte PO |
| Weken 6-8 | Massaproductie, inline QC, verpakking | Vooruitgang bewaken, PSI boeken |
| Week 9 | Review inspection results and follow the agreed payment and shipping terms. | Inspectie goedkeuren, vracht regelen |
| Week 10 | Inklaring, levering | Inventaris ontvangen, aanbiedingen activeren |
Wanneer ODM OEM verslaat
ODM may suit a project that fits an existing platform. Compare MOQ, customization, tooling or setup charges, testing, schedule, IP terms, and total cost with an OEM proposal; confirm any trial quantity in writing.
7. Waar OEM tijdlijnen eigenlijk stuklopen
The following factors can affect a project schedule; assess them against the supplier plan and current service estimates.

Mold revisions and design changes
Review design and tooling changes before fabrication. Record approval, cost, and schedule impact in the project plan.
Achterstanden in certificeringslabs - onzichtbaar totdat je vastzit
Laboratory availability varies by product, test scope, market, season, and provider. Confirm current availability and whether representative samples can be evaluated.
Chinees Nieuwjaar - de verstoring die je 12 maanden van tevoren kunt zien aankomen
Chinese New Year dates and supplier closures vary by year and factory. Check the official calendar and obtain planned closure and restart dates from each supplier; use a project-specific buffer.
Verpakking en product komen op verschillende tijden aan
Packaging may come from a separate supplier. Coordinate artwork, quantity, production, and delivery dates with the packaging supplier.
Voorbeeld revisielussen - feedback die blijft komen
Revision rounds can extend sample approval. Consolidate feedback in one document, rank issues, and confirm the schedule impact of each approved change.
Onderdeeltekorten - het probleem van de toeleveringsketen dat halverwege de productie opduikt
Components such as PCBs and batteries can affect timing if supply is not confirmed. Ask the supplier to document availability and proposed alternatives; assess any substitution through change control. A second source may help where technically and contractually feasible.
Vertragingen in verzending en havens - de laatste kilometers die weken toevoegen
Freight schedules vary with routing, capacity, port conditions, documents, and customs. Use current estimates and allow a project-specific buffer.
Keep milestones and decisions visible
Agree on a regular update cadence and document milestones, open issues, and decisions. Follow up on unexplained communication gaps and assess their effect on the project schedule.
8. Omgekeerde kalenderplanning: Werk achterwaarts vanaf je lanceerdatum
Reverse-calendar planning can clarify dependencies. Work backward from a target availability date using supplier, testing, production, freight, customs, and warehouse estimates confirmed for the project.

Voorbeeld: Planning voor een Amazon Q4 Holiday Season-lancering
Illustrative target only: confirm current event eligibility, FBA appointments, receiving requirements, and the actual transit plan; this is not an official deadline.
| Mijlpaal | Streefdatum | Opmerkingen |
|---|---|---|
| Producten ontvangen in FBA magazijn | 1 oktober | Allow for current FBA appointment, receiving, and processing times; these vary and are not a fixed 1–2-week guarantee. |
| Douane-inklaring + laatste mijl levering | 25 september | Illustrative only; confirm port, clearance, and last-mile timing for the route. |
| Schip van Shenzhen (zeevracht) | 28 augustus | Illustrative port-to-port estimate only; confirm current route, service, and door-to-door timing with the forwarder. |
| Pre-shipment inspectie geslaagd | 21 augustus | Allow time for inspection and documents according to the agreed scope and route. |
| Massaproductie voltooid | 14 augustus | Illustrative production window; confirm current capacity and schedule. |
| Purchase Order issued / payment milestone per contract | 17 juli | Start massaproductie |
| Pre-productie monster goedgekeurd | 10 juli | Allow for sample review and applicable testing; confirm scope and laboratory schedule. |
| T1 ontvangen schimmelmonsters | 26 juni | Review time depends on findings, corrective work, and approval. |
| Start fabricage mallen | 5 juni | Illustrative tooling window; request a project-specific estimate. |
| Fabriek geselecteerd, contract getekend | 29 mei | NDA, ontwerp matrijs goedgekeurd |
| Start RFQ-verkenning | 22 mei | Begin hier met zoeken naar een fabriek |
Voor een 1 oktober Amazon FBA lancering: Begin je zoektocht naar een fabriek voor 22 mei
May 22 to October 1 is 132 days, about 18 weeks and 6 days in this example. This is a planning window, not a promise; update dates as milestones are confirmed.
Als je de etalage van mei hebt gemist: compare a suitable existing-platform ODM option or revise the launch target. Actual timing and seasonal demand depend on the project and market.
Timing voor het hoogseizoen

| Doel Lanceervenster | Illustrative OEM Start Date | Illustrative ODM Start Date | Opmerkingen |
|---|---|---|---|
| Januari (Nieuwjaar) | 1 september | 15 oktober | Check the official calendar and obtain supplier closure and restart dates for the relevant year. |
| Februari (Valentijnsdag) | 15 oktober | 1 december | Illustrative note only; confirm the official holiday calendar and each supplier’s closure and restart dates. |
| April (Lente) | 1 december | 15 januari | Confirm supplier availability and restart dates for the relevant year. |
| Juli (Prime Day) | 1 maart | 15 april | Illustrative example only; verify current supplier and logistics availability. |
| Oktober (pre-vakantie) | 22 mei | 15 juli | Illustrative channel note; verify current market conditions. |
| November (zwarte vrijdag) | 15 juni | 1 augustus | Confirm current event-specific eligibility and submission dates; no universal October 15 cutoff is asserted. |
Verwijzingen

9. Veelgestelde vragen
Ontvang een persoonlijke OEM tijdlijn voor uw project
Tell us your target launch date and product requirements. Our project team can discuss a project-specific schedule and applicable commercial terms.
Tip: Include your target launch date, destination market, and product requirements so the schedule discussion can account for project constraints.

Ga door met uw OEM-onderzoek
- De complete gids voor OEM/ODM elektrische tandenborstel productie (2026): Volledig overzicht van kosten, certificeringen, kwaliteitscontrole, fabrieksselectie
- OEM vs ODM vs OBM: Welk productiemodel is geschikt voor uw merk?: Beslissingskader met reële kostenvergelijkingen
- Hoe vind ik een OEM-fabrikant in China: 6 bewezen methodes: Canton Fair, Alibaba, fabrieksaudits en due diligence
- CE, FCC, PSE en meer: De complete certificeringsgids voor elektrische tandenborstels: Elke certificering die je nodig hebt, per markt
- Gids voor huismerken: Van logo tot lancering: Verpakkingsontwerp, merkidentiteit en marktintroductiestrategie
- OEM/ODM koopgids voor waterflossers: Uitbreiden naar een mondverzorgingslijn met meerdere producten? Begin hier
